CHAPTER 10

Responsibilities

In this chapter, we discuss managing the development and administration of a successful ETL system. We could have put this chapter at the beginning of the book, before the myriad responsibilities of the ETL system were discussed thoroughly, but we think by putting it at the end of the book, you will better be able to visualize how to manage a team effectively.

The first part of this chapter looks at planning and leadership issues, and the second part descends into more detail of managing the ETL system. Many of these perspectives were developed in Data Warehouse Lifecycle Toolkit.

PROCESS CHECK Planning & Design:

Requirements/Realities → Architecture → Implementation → Release to Ops

Data Flow: ExtractCleanConformDeliver

Planning and Leadership

In some ways, the data warehouse and ETL process are just like any other software development project. When a data warehouse team is established, it usually requires three specialists. The following list contains common roles required to initiate a data warehouse project. The list includes the primary role and the secondary role (in parentheses) that the same individual can perform on small teams.

Data Modeler (Project Manager). The data modeler must be specially trained in dimensional data modeling and educated in the principles of dimensional modeling.

ETL Architect/Programmer (DW Architect). The ETL programmer is usually a SQL and database expert as well as an architect. This person establishes the technical infrastructure of the ETL system and data warehouse environment and designs the physical ETL processes.

Application Specialist (Business Analyst). This person gathers and documents the business, analytical, and reporting requirements. This specialist writes the front-end interface and initial reports for the data warehouse. This position is often called the business intelligence (BI) specialist.

When a data warehouse is kicked off, the often compact team of highly specialized individuals builds the foundation for what evolves into the most visible, widely used database application in your enterprise. Like any other substantial structure, without a thoroughly planned and methodical construction of the foundation, anything built subsequently is certain to topple.

Having Dedicated Leadership

The data warehouse is a complex entity that requires specialized knowledge that most enterprise IT managers don’t quite understand. Initially, the data warehouse must have a dedicated project manager who has experience implementing a data warehouse using the principles of dimensional modeling. As your data warehouse evolves, each component and subcomponent must have a dedicated project manager. A mature data warehouse must a have distinct ETL, data-modeling, and business-intelligence managers as well as a dedicated project manager who oversees all of the departments of the data warehouse team to ensure a cohesive solution is implemented across all areas.

It’s been argued that a single person can manage the entire data warehouse, but we strongly recommend that specialists for each area be appointed. Each area requires specialized skills that become diluted if someone tries to encompass them all. Remember, a single mind, no matter how strong, is not as strong as a group.

A group is always stronger than an individual, but that does not mean that design decisions are made by voting! Design decisions are best made autocratically, so that consistency is maintained.

Planning Large, Building Small

When you are building a data warehouse from scratch, it is often difficult to imagine that it is going to evolve from the single data mart you are working on into a major enterprise, mission-critical application that has more exposure than any other application within your company. The big picture is commonly lost because data warehouses are usually built in an iterative approach. They start and complete a single business process or data mart, such as human resources or campaign management, before development of the next data mart begins.

The data warehouse architect must utilize a methodology known as data warehouse bus architecture, which outlines the framework of the data warehouse so all of the resulting data marts work together in a cohesive fashion using conformed dimensions and conformed facts as we have described extensively in this book.

Part of the data warehouse bus architecture process includes devising a data warehouse bus matrix, a list of all the dimensions that need to be created and their associations to the various data marts in the data warehouse. The bus matrix helps the architect visualize which dimensions are shared or conformed across the various data marts in the data warehouse. Once the bus matrix is created, the physical data marts can be built one at a time. Figure 10.1 illustrates a sample data warehouse bus matrix.

Figure 10.1 Data warehouse bus matrix.

Just as certain dimensions are reused throughout the data warehouse, certain ETL routines are reused over and over when you are building the ETL processes. For example, your first ETL process most likely includes generating a surrogate key for a dimension. The code that generates the surrogate key can be reused to generate all surrogate keys in the data warehouse—just by using different parameters. If you come from a software development background, you may have heard the saying, Write once, use many. That adage means to reuse as much code as possible. Not only does reusable code cut down development time of subsequent processes; it ensures consistency across them.

You need an effective code-reusability strategy. Establish an environment that encourages developers to share ideas and to trust each other’s work. The following tips can help you build a team environment.

Agree as a group on strategies. Have regular meetings that discuss technical and functional strategies and solve problems as a group.

Share ideas as well as code. Reinforce that ETL development is not a competitive sport. Work together and share issues with others on your team. We’ve spent hours in isolation agonizing over situations. Then, by simply explaining the scenario to someone else, the solution instantly came to mind. It’s amazing how many ideas are born during simple conversation.

Use a repository. Many ETL tools offer a repository for reusable code. Make sure your tool includes a repository that allows code to be reused and shared among various load routines and developers. If you have not yet invested in a dedicated ETL tool, at least use a source-code repository such as SourceSafe or PVCS. In mature installations, you need to develop multiple individual repositories which then must be managed as a single virtual repository.

Once your team is trained to work together and all of your core routines are in your repository, development efficiency is sure to increase. Also, working together helps developers understand the big picture of the project. Avoid isolating developers by subject area. Over time, each developer becomes an expert in the specific areas he or she develops. It is advantageous for the team to be exposed to other areas for which they are not directly responsible. Broadening the scope of ETL developers promotes cross-functional planning and builds morale within the team.

Your ETL team should be encouraged to share and reuse as much of their work as possible. Make sure appropriate metadata is associated to all of the sharable code in your repository. Metadata is crucial for identifying the purpose of the code and providing instructions for its use. But be realistic in your expectations for literally reusing code across separate operating systems and DBMS platforms.

Hiring Qualified Developers

Skilled ETL developers are invaluable assets to your organization. However, skill alone does not qualify someone as an expert. We’ve interviewed many potential ETL developers over the years who knew various tools inside and out but could not grasp dimensional concepts such as hierarchy mapping tables. Developers must have the ability to comprehend new techniques quickly and implement them with minimal hand-holding. When we interview, we tend to spend less time talking about using tool features and more time on problem solving—technical and functional. We find that candidates with intelligence and character make much better ETL team members than those with only technical skill.

During candidate interviews, ask a specific question you know the interviewee does not know the answer to. Watch to see how he or she works it out. Remember, it’s not whether the candidate gets the answer right, but the process he or she uses to solve it. The reality is that ETL and data warehousing can be quite complex and are quite specialized. Still, it’s not splitting atoms. (If it were, a scientist would have to provide a specification!) So, when you are building your team, make sure that your developers are motivated to grow technically and professionally. They must be able to grow with you and your project and be able to accept and adapt new techniques and strategies.

Building Teams with Database Expertise

Part of the responsibility of the ETL manager is to inventory all of the source systems within your enterprise and align the appropriate skill sets in your development team according to the existing databases. If you use a dedicated ETL tool, staffing your team with specific database expertise might not be as critical. But even with the best toolsets, you never seem to get away from rolling up your sleeves and writing raw SQL at some point in the ETL development process.

Listing specific SQL coding tips and techniques is beyond the scope of this book—there are several SQL books on the market—but be advised that SQL is the foundation of any DBMS query. Tools alone cannot adequately fulfill all of your ETL requirements. When you interview potential candidates for your ETL team, be sure they are proficient in the specific flavors of SQL required both for your transaction DBMSs as well as the system you have chosen for your main ETL processing.

Each source system DBMS that you encounter requires knowledge and implementation of specialized SQL syntax. Make sure your team has the specialized skills to navigate the various databases and that your ETL tool can seamlessly integrate native SQL code in the ETL process without leaving the application.

Don’t Try to Save the World

The ETL system is just a portion of the data warehouse project, and some things that happen within it are beyond your control. Accept that the data warehouse is not, nor will be, perfect. You are going to encounter dirty data, and in many cases, you will not get the political backing to clean it. Our philosophy is that the best way to get data cleansed is to expose it. You’ve been asked to build the data warehouse because the existing data has been so difficult to analyze. Chances are that much of the data you are publishing with your ETL process has not been exposed before, especially to the extent that it is via the data warehouse. If your petition for ultimate data quality is ignored, be patient. As soon as blemished data is published, managers have to start explaining the anomalies, and you will witness a change in heart about the quality of the data and receive the support you need.

Enforcing Standardization

In large ETL projects, it is imperative that you establish standards early on. Without standards, developers write inconsistent ETL jobs and cause the maintenance of existing code to be horrendous. The ETL team must standardize their development techniques to provide a consistent and maintainable code environment. The following list contains areas of the ETL process that need standardization most:

Naming conventions. Establish and enforce a standardized convention for naming objects and code elements in your ETL process. Begin by adopting existing naming standards in your organization. Add to your existing conventions with those recommended by your ETL tool vendor.

Best practices. Document and follow best practices for building your ETL routines. Make standards for things such as the ordinal position of transformations in your routines or the best ways to recover from a failed process. This book is full of recommended strategies for your ETL processes. Standards to consider are:

Generating surrogate keys. If you decide to use the database, ETL tool, or any other mechanism to generate surrogate keys, be consistent throughout your ETL jobs.

Looking up keys. You may use mapping tables, look to the physical dimensions, or use other staging techniques to associate natural keys to their surrogates. Pick one and stick with it. If you mix techniques, maintaining these routines is a nightmare.

Applying default values. Several approaches and values are acceptable means of defaulting missing values. Remember that missing values or NULL values have to be handled carefully in the data warehouse because those values can cause blank column or row headings on reports and because some databases do not include NULLs in their indexes. It’s best to check incoming records for NULL values and to substitute them with actual values such as the single character ? during the ETL process.

Monitoring, Auditing, and Publishing Statistics

ETL statistics are invaluable to anyone who uses the data warehouse. If your data warehouse has a dedicated Web site—and it should—make sure it includes the daily statistics of your ETL processes. Users often want to know exactly when a table has been loaded or if any rows were rejected. Most ETL tools generate load statistics automatically. Make sure your tool has the ability to automatically publish the required statistical information upon completion of the daily data load.

CROSS-REFERENCE A list of the statistical elements that should be published as part of your metadata strategy can be found in Chapter 9.

Maintaining Documentation

Documentation of what your ETL processes do is an invaluable asset to the data warehouse team and has become mandatory in many phases of financial and regulatory-reporting data warehouses. Even with the most thorough logical data-map specification, only the developer knows exactly what is done to the data between the data warehouse and its source. It’s the responsibility of the ETL team to maintain documentation for the lineage of each data element in the data warehouse with rigorous change control. Some documentation comes in the form of metadata, but not all forms of documentation are considered formal metadata. Metadata is a complicated entity that already has several books to explain its capacity. Regardless of how you categorize it, several pieces of documentation must exist and be maintained and published. Often, descriptions of processes cannot be captured in the allotted fields in the various tools designed to capture this information. Inevitably, you need to provide documentation that explains your ETL processes in Word documents, Excel spreadsheets, PowerPoint presentations, and so on. Use a version control system such as SourceSafe or PVCS to maintain the integrity of your documentation.

Providing and Utilizing Metadata

Metadata is crucial for sharing and reusing ETL processes. Virtually all ETL tools have the ability to capture and utilize metadata. Don’t do your team an injustice by creating processes without metadata. Each time you create a new ETL process, keep this in mind: If it’s not captured by metadata, it doesn’t exist. This is true in established data warehouse environments. If you don’t expose your work via metadata, someone else on your team may recreate from scratch something that you’ve already created and tested.

What’s more, the ETL tool repository is often the home of the metadata repository. Some ETL tools have the ability to transmit existing metadata from other tools such as data-modeling or reporting tools and associate elements for impact analysis. Some business-intelligence tools can utilize the ETL repository to integrate metadata with the data warehouse user interface. If the metadata in the ETL environment is published, it must be maintained, or the toolset can publish out-of-date information to its users.

Keeping It Simple

If you think there has to be an easier way to so something, there usually is. When you are building your ETL processes, take a step back from time to time and look at your work from a design perspective. Is the design straightforward, or does it have complexities that could be avoided? The more complex your processes are, the more difficult they will be to maintain. Moreover, complex ETL designs are almost impossible to evolve. As business needs or source systems change, your ETL jobs must be adaptable enough to change with them. We were called on a project once where an ETL job was so complex it was untouchable. No one knew exactly what it did, so no one was able to modify it. It was so convoluted that we were hired to reverse-engineer, document, and redesign it into a more streamlined, manageable process.

Optimizing Throughput

No real limitation exists as to how elaborate your ETL processes can be to transform your source data into usable information for the data warehouse. However, a restriction on how long your jobs can take to process does exist. One of the challenges to being an ETL developer is to have the ability to extract, clean, conform, and load data within the allotted load window. The load window is the time set aside each night to run the ETL processes. Usually, the data warehouse is not available to its users during the load window, so there is always pressure to keep the load window as small as possible.

Managing the Project

The ETL process is a critical piece of the data warehouse project. Until now, it has been thought of as the least glamorous aspect of the project and typically did not receive the attention it deserved. In the early days of data warehousing, the primary focus was on front-end tools; then as the size of data warehouses began to grow, the dimensional data model became the next focal point. As the data warehouse reaches its next level of maturity, ETL is finally getting appropriate time in the spotlight.

Most designers agree that at least 70 percent of the entire data warehouse project is dedicated to the ETL process. Managing the team that builds these tenacious processes responsible for transforming potentially billions of rows of unorganized data from disparate systems into a cohesive user-friendly information repository is an achievement that is highly regarded by technologists and executives alike. Managing the ETL team takes dedication and know-how.

The ETL manager position has been established to alleviate the overwhelming responsibility of the ETL process from the data warehouse project manager. Also, this position provides business sponsors with confidence that the ETL team can maintain a controlled, efficient environment to load the data warehouse with clean, consistent data. The tasks contained in this chapter should be read carefully by all members of the data warehouse team to make certain that they understand that the ETL process is not a trivial byproduct of the data warehouse project but rather the glue that holds the entire project together. To the ETL manager, this chapter offers the knowledge required to bring your ETL project to victory.

Responsibility of the ETL Team

At the most rudimentary level, the ETL team is responsible for extracting data from the source system, performing data transformations, and loading transformed data into the target data warehouse. More specifically, to achieve optimal ETL results, the following tasks are the responsibilities of the ETL team:

Defining the scope of the ETL

Performing source system data analysis

Defining a data-quality strategy

Working with business users to gather and document business rules

Developing and implementing physical ETL code

Creating and executing unit and QA test plans

Implementing production

Performing system maintenance

To effectively manage your team in the execution of the preceding tasks, we’ve outlined an actual project plan that incorporates these tasks and gives details of your functional responsibility for properly managing each.

Defining the Project

Although the ETL process is only one of the many components in the data warehouse lifecycle, it is the center of the data warehouse universe. Moreover, the ETL process is by far the most difficult component to manage. As users begin to see the resulting data in the beginning phases of the project, you will be faced with an onslaught of change requests. Without a properly executed project plan and change-management strategy, managing the ETL process will seem impossible, a never-ending task that could delay the project to the point of failure. As you go about defining your project, keep the following guidelines in mind:

For a seamless process, the management of the ETL must be closely coupled with the other components within the data warehouse lifecycle. From the standpoint of those who work with it regularly, the data warehouse is never really finished. As new requirements are initiated, the modeling team, ETL team, and reporting team must work together to effectively accomplish these new goals and complete the tasks that lie ahead. Steps outlined in this chapter should be reused as each subject area is added to the ever-evolving data warehouse. Nailing down the methods outlined in this chapter is crucial to properly managing these iterative processes.

Be realistic when estimating completion dates and defining scope. Do not let data modelers or business sponsors who do not have the knowledge to make an informed decision dictate the time frame of the ETL effort. Use the project plan in this chapter as a guide and make sure your business users and sponsors are aware of exactly what is involved in loading your data warehouse.

Make sure the ETL team is an active participant in the data warehouse project kick-off meeting. Such a meeting can be a venue where you introduce the ETL team to key business users and discuss the ETL-specific goals, roles and responsibilities, and timeframes. Create an environment that fosters collaboration. This meeting helps participants understand project needs, and it gives you the opportunity to manage expectations.

Planning the Project

What is a plan? A plan is a method of action, procedure, or arrangement. It is a program to be done. It is a design to carry into effect, an idea, a thought, a project or a development. Therefore, a plan is a concrete means to help you fulfill your desires. — Earl Prevette

It is your ultimate goal as an ETL manager to successfully manage the ETL process and integrate the process into all other phases of the lifecycle. You might assume that managing the ETL process is identical to managing any other implementation, but it is quite different. In this section, we explain the methods that have helped us achieve successful implementations. Also, we expose many obstacles you may be faced with and provide suggestions to mitigate those risks to achieve your goals.

As a prerequisite to beginning the iterative portions of the project plan, you need to complete a few housekeeping responsibilities. These tasks include determining your ETL tool set and staffing your project team.

The order in which these two tasks are executed is important. You want to select your ETL tool set prior to staffing your team. Doing so will enable you to recruit individuals who specialize in your selected tool set.

Determining the Tool Set

The ETL manager must determine whether it makes sense to build the ETL processes by hand or to purchase an ETL tool set, as discussed in Chapter 1. There are many arguments for either case. However, with the success of enterprise data warehousing and the expectations of executive sponsors, we feel there is no time for hand-coding, especially when you consider the iterative nature of data warehousing. Even the smallest projects benefit from the transformation reusability of dedicated ETL tools. The features available in these tools, right out of the box, would take months to design manually, not to mention coding the actual data-transformation processes. The reduced development time obtained via these tools makes them viable solutions for any data warehouse project.

Furthermore, ETL tools are specifically designed for the task at hand. The most popular case we hear for building over buying is that programmers already know SQL. Why waste time learning a tool that essentially has the same result: moving data? Two analogies immediately come to mind when we hear this. First, if the only tool you know is a hammer, everything around you is treated like a nail. Setting screws becomes very difficult, laborious, and sloppy. The second is the secretary that didn’t have time to learn word processing because she was too busy typing. As silly as this may sound, it is synonymous to not training your SQL programmers in dedicated state-of-the-art ETL tools to perform their assignments.

To aid in the decision-making process, we recommend documenting your tool-selection criteria. Establish proof-of-concept decisive factors such as throughput performance, ease of modification, and vendor support and then perform a proof-of-concept for the tools (including a comparison with hand-coding) that you feel may meet your criteria. Upon evaluation of your proof-of-concept results, you will be able to make a firm decision on whether to build or buy an ETL tool set. If you are purchasing, you will have a firm idea of exactly which tool fits your needs.

Staffing Your Project

A crucial factor in managing the ETL process is establishing a superior team. Your team members must possess the necessary skills to perform the duties expected of them. A properly trained team is vital to your success. Ensuring that all team members fit into the company culture and work well together is equally important.

Before data warehousing reached its current point of maturity, all duties of the project were typically performed by just a few data warehouse experts. These all-encompassing experts interviewed business users, documented requirements, designed the data model, loaded the database, and so on. As the data warehouse project evolves, we are discovering that each of these specific tasks requires a unique set of specialized skills and that no individual can achieve expertise in all of them.

ETL Team Roles and Responsibilities

Staffing the roles of the ETL team is an undertaking that must be reckoned with. If you have appropriate knowledge internally, you may be able to recruit or train your internal staff. Otherwise, you need to work with recruiters to find the appropriate expertise required to construct your team.

The following bulleted list explains the roles and responsibilities we’ve found to be fundamental to building an optimal ETL team.

Staffing one person per specific role would be ideal. However, as circumstances dictate, it is realistic to have people play multiple roles by overlapping some of their responsibilities, depending on the size of your project. Remember when you are staffing the project team, your main goal is to ensure that all duties will be performed. You do not necessarily have to fill each role with a dedicated person.

ETL Manager. This individual is responsible for the day-to-day management of ETL team and the on-going data warehouse maintenance as it relates to the ETL process. The ETL manager is accountable for managing the development of the data-extract, transform, and load processes within the data warehouse and oversees its testing and quality assurance. The ETL manager also develops standards and procedures for the ETL environment, including naming conventions and best-development and design practices.

ETL Architect. Primary responsibilities for this individual include designing the architecture and infrastructure of the ETL environment and designing the logical data mappings for the ETL development team. This architect must have a strong understanding of the business requirements and the source operational systems. The ETL architect is responsible for resolving complex technical issues for the team and migrating ETL routines to production.

ETL Developer. This individual is accountable for building the physical ETL processes. The ETL developer works closely with the architect to resolve any ambiguity in specifications before actual coding begins. The developer is responsible for creating functional ETL routines and testing their reliability to ensure that they comply with business requirements. There are usually several ETL developers assigned to a data warehouse project.

Systems Analyst. The systems analyst is accountable for business requirements definition activities and documenting those requirements throughout the data warehouse lifecycle. The systems analyst works closely with all members of the data warehouse team and the business users.

Data-Quality Specialist. Data-warehouse quality includes the quality of the content and the information structure within the data warehouse. The data-quality specialist typically reports to the ETL manager but may also report directly to the data warehouse project manager. The data-quality specialist primarily works with the systems analyst and the ETL architect to ensure that business rules and data definitions are propagated throughout the ETL processes.

Database Administrator (DBA). The DBA is primarily responsible for translating the logical database design into a physical structure and maintaining the physical database. Moreover, the DBA works very closely with the ETL team to ensure that new processes do not corrupt existing data. In some environments, the DBA actually owns the ETL process once it is migrated to production.

Dimension Manager. The dimension manager is responsible for defining, building, and publishing one or more conformed dimensions to the extended data warehouse community that agrees to use the conformed dimensions. This is a truly centralized responsibility. Conformed dimensions must be version-stamped and replicated simultaneously to all fact table provider clients. There can be more than one dimension manager in an organization, since the data content of each dimension is largely independent. In any case, a given dimension is the responsibility of a single dimension manager.

Fact Table Provider. The fact table provider owns a specific fact table. In a conformed dimension environment, the fact table provider receives periodic updates of dimensions from dimension managers, converts the natural keys in the fact tables to the dimension’s surrogate keys, and exposes the fact table appropriately to the user community.

ETL Project Team Staffing Options

The old aphorism you are only as good as your subordinates holds special importance in a mission-critical environment like the ETL process of the data warehouse. An intelligent approach to preventing project failure is to build a superlative team to develop it. This section discusses various options available to you while building your ETL team.

Working with Recruiters

More often than not, you will need to look outside your organization while building your ETL team. Typically, organizations work with dedicated recruiters to seek the best candidates. But, just as a data warehouse needs to be fed complete, reliable information to be valuable to its users, you need to provide precise requirements to your recruiters for them to be effective. Be as detailed as possible when you supply job qualifications to ensure that you receive candidates that possess the skills and work habits you are looking for. Let the recruiter know the details of your environment, especially emphasizing your programming languages, vendor packages, and database systems. Also describe the dynamics of your team and exactly what type of person you are looking for. Provide the most detail possible to ensure that the candidates they send will meet your expectations.

Recruiting companies that specialize in data warehouse staffing will give you the benefit of working with recruiters who are knowledgeable in the data warehouse industry and the tools sets that support it. They are responsible for pre-screening candidates and weeding out under-qualified individuals before forwarding any resumes to you, limiting the number of lacking resumes and individuals you need to evaluate. You will be busy enough with many other tasks; the time saved using qualified recruiters is well worth their fees.

Hiring Internally versus Externally

There are advantages to building your team from either internal or external sources. The benefits of hiring internally include the following:

The primary benefit of performing internal searches and hiring from within your organization is that internal individuals already have a strong understanding of your organizational structure and IT systems. They know who is responsible for what; who to go to for answers; and how to get things done politically. If you’re lucky, they may already possess the skills needed to fill a specific role within the team. If an individual does not have the desired skill level but do have the potential and desire to be trained appropriately, this person may very well be a candidate worth considering.

Providing internal employees who possess motivation with the opportunity to learn new things keeps them challenged and satisfies their needs.

There is an economic benefit to hiring internally: It will most likely be more cost effective to hire from within than to go through a recruiter and incur placement fees, interview expense reimbursements, relocation costs, and so on.

If you hire externally, you hire an individual who possesses the skills you are looking for as well as experience using those skills in several different business cultures. This experience offers more than its face value. Experience saves you time and money while adding value to your team.

Selecting Team Members

Once you are armed with a handful of resumes, we recommend that you schedule a telephone interview to speak with potential candidates before bringing them in. Asking key questions over the phone instantly reveals their communication skills and level of understanding of the subject matter.

Candidates that pass phone screenings should be brought in for face-to-face interviews. Your candidates should be questioned not only by the ETL manager but also by technical developers, as well as by functional analysts. Having candidates meet both functional and technical individuals gives you the ability to gauge how broad their proficiency is. We’ve had many unpleasant experiences where team members were technically proficient but did not (and could not) grasp the functional picture. Their inability required extra work on the part of other team members to ensure their work actually met the business needs.

You need to be convinced, without a doubt, that all potential members of your team have sufficient knowledge in ETL process design, ample skill in required tool sets, and appropriate aptitude of business processes to comprehend functional requirements. The ability to work collaboratively with the rest of your team is crucial. Be sure to inquire about team dynamics on previous projects during your interviews.

During candidate screening and interviewing, it is essential that you and your recruiters are not only knowledgeable about the role they are seeking to fill but also know the appropriate questions to ask. Figure 10.2 includes an interview questionnaire that provides you with questions you need during the interview process. Using this questionnaire helps ensure your candidate’s knowledge is sufficient for the specific role. Answers to the questionnaire are sprinkled throughout the book.

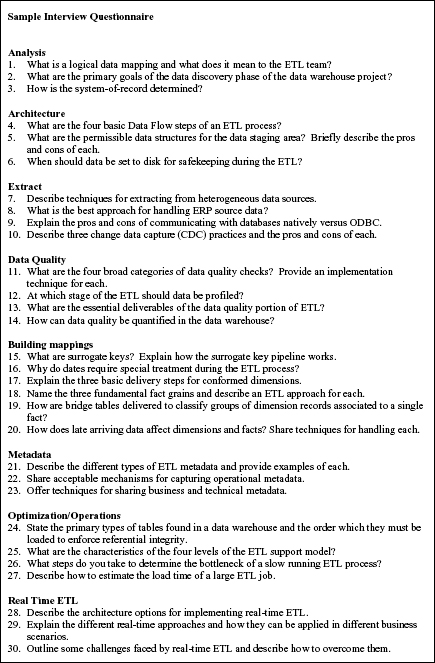

Figure 10.2 Sample interview questionnaire.

Building and Retaining a Winning ETL Team

Once you have staffed your team, your main responsibility as a manager begins. Retaining a first-rate team is among your biggest challenges. Superstar ETL personnel are in very high demand, and recruiters are not shy about poaching them from right under your nose. We find the best way to keep the majority of ETL developers and architects on our projects is to keep them challenged technically. In our experience, a bored technologist will be a departing one. It is your responsibility to assign projects that keep your team members interested and excited.

The tasks that the ETL developer accomplishes are not trivial. They step up to the plate acknowledging it is their responsibility to transform unorganized, disparate data into cohesive valuable information, an intense, sometimes grueling undertaking. Do not take them for granted. Be attentive of their needs; know what makes them tick and starts their fire. We’ve worked with some developers that just love to clean data. They find making consistent reliable data from garbage to be rewarding. Others cannot be bothered. They feel that if data is so important, it would be clean in the source; those developers would much rather be challenged with solving nearly impossible SQL puzzles like converting data from tremendously complex data models into simple dimensional ones. Other developers just love to race the clock. If an ETL process should take one week to develop, they work furiously to have it complete in just a few days. Part of your responsibility as manager is to know what kind of developers you have and keep them challenged.

If team members are eager and able to accept more responsibility, give it to them. It’s your duty to navigate each individual’s desires and try to fulfill them. Also, you need to provide team members with the training they need to ensure they are the best at what they do. If you let your staff stagnate, they will leave the project and move on to a more challenging environment.

An effective approach to keeping in tune with your subordinates needs is to hold weekly status meetings. The ETL environment is a volatile one, and letting more than a week elapse without receiving your team’s feedback on progress could be detrimental to the project. These dual-purpose meetings make sure team members are meeting their goals and that you are meeting yours. Give them responsibility, empowering them to make decisions where doing so makes sense. Moreover, you should foster an environment where team members can voice concerns, convey development needs, and so on. They must be able to rely on their ETL manager to take action on rectifying their problems. A well-managed staff is a satisfied one.

Outsourcing the ETL Development

Outsourcing IT responsibilities is a hot topic as we write. Yet the overall numbers are smaller than the talk would suggest. In 2003, of the $119 billion spent in the United States on IT budgets, less than five percent was reportedly vulnerable to outsourcing. In recent reports, some of the hoopla surrounding outsourcing savings is being offset by realizing that over time, managing outsourcing projects involves extra communication, travel to foreign countries, and resetting of expectations and deliverables that did not appear in the original financial savings projections. We are not saying that outsourcing is a bad idea, but we are cautioning that outsourcing is a tricky topic as far as the data warehouse is concerned.

The data warehouse must always respond to the data sources de jure, as well as to the changing priorities of management and the end user community. As we have said many times, the data warehouse is not a project (with specifications and a final delivery) but is rather a process that is on-going. Data warehouse development tasks are iterative and changing. In fact, that is one of the reasons we like the dimensional approach; it is the most resilient architecture for adapting to new surprises and changes in scope.

For these reasons, we are generally negative about outsourcing many of the data warehouse development tasks to remote parties and do not engage in regular contact with the source data suppliers as well as the end users. Remember that the data warehouse is a decision support system judged solely on whether it effectively supports decisions.

ETL system development does provide selected opportunities to outsource development tasks, if you have a specific transformation that can be well specified.

Project Plan Guidelines

Now that you have decided on your tool set and staffed your ETL project team, you are ready to dive into the heart of the ETL project plan. In this section, we provide a detailed project plan that any ETL team can utilize.

Given the cyclical nature of data warehouse phases, the project plan can, and should, be reused with each phase of your data warehouse project. Consistent use of these guidelines enforces standards and ensures that no steps are forgotten.

Details of each step are explained in the remaining portion of this chapter. High-level steps for managing the ETL process are shown as a project plan in Figure 10.3.

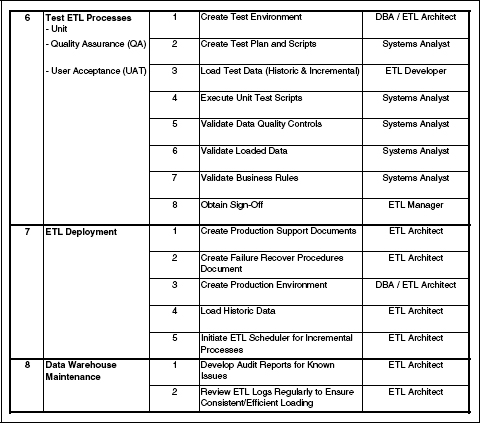

Figure 10.3 ETL Project Plan.

Building the Development Environment

To perform thorough data analysis and begin ETL development of any source system, it is good practice to have the DBA team build a development environment. Use of a separate development environment guarantees that data analysis and ETL development will not affect the production transaction system. Once the environment has been set up, the ETL architect and the DBA team work together to install the appropriate software and tool sets required to perform the analysis and development activities for your team.

Be sure to document the course of actions required and create the development environment during your first phase of the project. Documenting standards from lessons learned minimizes future errors and risk to the added systems during subsequent iterations.

Business Requirements Analysis

Although many of the business rules have been documented through analysis during data-modeling sessions, the ETL architect’s is responsibility to take those rules to their completion. Typically, the ETL architect and the systems analyst review all existing documentation and meet with data modelers to discuss questions that arise.

It is critical that the ETL architect and systems analyst have a solid understanding of the source systems and the data inside them. Be sure not to underestimate the time needed to complete this analysis, and keep in mind that the logical data mapping cannot be created until the source systems have been thoroughly analyzed. It is not uncommon for the ETL architect and systems analyst to meet with the data modelers, the source system DBAs, or system analysts for multiple sessions, depending on scope, to review details of the source systems. These sessions will facilitate the findings of business rules that will be used to build the logical data mappings and finally code the ETL process.

Figure 10.4 is a sample template for gathering and documenting business rules and data defects. The spreadsheet is broken out as such to allow the tracking of either data clean up or ETL details or both. We have combined the two into one template because the ETL architect typically has to tackle

Figure 10.4 Business rules and data defect tracking spreadsheet.

the business rules and data clean-up transformations simultaneously for a cohesive, integrated solution. It is important that these rules and transformations are thoroughly documented in detail, not only for purposes of coding but also because this document is the foundation of the creation of unit, system, QA, and user acceptance testing test cases. This metadata is also used for end user training and procedures documents.

In theory, emphasis is always placed on documentation. Unfortunately, in reality it is common for project teams to start off with good intentions by creating the documentation, but they rarely go back and update the documents as things change. Do not fall into this trap. Keeping documentation up to date is crucial to the success of your project. Up-to-date documentation is mandatory to perform detailed impact analysis of future enhancements and subsequent phases of your project. Moreover, current documentation ensures that you have a handle on the data lineage of your warehouse. Maintaining your documentation may require time and effort, but consider the alternative: going back and trying to figure out what has changed within ETL processes, business rules, or data after the fact. It doesn’t take a lot of imagination to visualize the wasted time, increased costs, and pure frustration that can be avoided by planning ahead and updating your documentation as modifications to your ETL processes are made.

Defining the Scope of the ETL project

Defining scope includes determining and documenting what will be included for each phase of the ETL process as it relates to subject areas, business rules, transformation, and data-cleansing strategies. It can also, and usually does, indicate what is not included in the phase. Documenting the scope of each phase and requiring business users to review and sign-off the scope documents aids in your management and prevents scope-creep.

Be realistic when defining each phase. Although your users expect you to fulfill your commitment, they will most likely make many changes and additions throughout the lifecycle of the phase. Changes to scope must be negotiated and prioritized, leaving low-priority changes for future phases. Keep potential scope-creep items on your radar when finalizing the scope documentation.

After business rules have been documented and scope has been defined, have a user-walkthrough of the documentation and obtain sign-off by the business users. Techniques for managing scope are discussed in the “Managing Scope’’ section of this chapter.

Designing the Logical Data Map

To help facilitate the design of the logical data map, the ETL architect must review the data warehouse data model and all business-rules documentation. Additional meetings may be needed to get answers for any remaining open questions and/or issues. If the existing business rules gathered during the business-requirements-analysis phase do not provide enough detail, the ETL architect needs to analyze the source systems manually. Once all questions and issues are resolved, the ETL architect creates the logical data-mapping document.

CROSS-REFERENCE Chapter 3 contains the exact details involved in creating the logical data map.

Defining a Data Quality Strategy

Other than being query friendly, the chief acceptance factor of any data warehouse is that the data is consistent and reliable. Therefore, conducting a data-quality assessment and defining a strategy is a vital part of the ETL process.

The ETL manager and the data-quality specialist are jointly responsible for defining data-quality rules. They are tasked with analyzing the quality of the source system data and documenting all identified data defects. This exercise not only ensures that the cleanest possible data is entering your data warehouse; it also benefits the source system from a data-quality perspective. This analysis exposes flaws in the source system applications and gives source system administrators the opportunity to make corrections to their application to prevent future data defects.

Options for cleaning data usually fall into two categories:

Cleanse data at the source.

Transform data in the ETL.

Cleansing data at the source is the most desirable and beneficial option. Unfortunately, it may be neither feasible, due to resource constraints, nor timely, due to the transaction application development lifecycle complexity and schedule. Additionally, data cleanup usually involves political navigation to settle on appropriate data defect correction activities.

After all details and deadlines are committed and agreed upon, document the details of each data-cleanup issue and associated cleanup resolution. Creating a project plan to track the issues to be cleansed in the source systems as well those to be cleansed by the ETL process will help you manage user expectations regarding data defects.

We recommend setting up weekly meetings with the administrators responsible for source system data cleanup. Use these meetings to review and update the project plan to accurately reflect progress and discuss any new findings. These meetings will determine the feasibility of cleanup and will provide a forum to agree on a strategy for cleaning up new findings. Be sure to stay on top of progress made to source-data cleansing, as your data warehouse is depending on source data being clean. It is a good idea to make the extra effort to query the source database to ensure the cleanup effort was successful.

Although data is being cleansed in the source system, the source system owners may not have the ability to add business rules to prevent data from becoming dirty again. Therefore, it is a good idea for the systems analyst and ETL architect to meet to determine whether ETL code is necessary to prevent dirty data from entering the data warehouse. ETL code can either kick out or transform dirty data, depending on the business rules.

If ETL code is used as a preventative measure, whether through exclusion or transformation, it is a good idea to define audit reports for the ETL processes to capture and report dirty data. Such reports aid in the continual cleanup of the source data and provide a mechanism to tie the corrected data in the data warehouse back to its source. This metadata also serves as an audit trail that provides the ability to trace a data discrepancy to its place of origin, identifying the data owner responsible for its cleanup. Be sure to obtain user sign-off on the business rules and data cleanup logic being handled by the ETL.

Building the Physical ETL Process

Once the data analysis is complete and the business rules and logical data mappings are final, the ETL architect walks through the logical data mapping with the assigned ETL developer. This walkthrough ensures that the ETL developer understands the complete requirements before he or she begins coding. The ETL developer is responsible for forward engineering the logical data mapping into physical ETL routines. Whether SQL scripts are written or a dedicated ETL tool is used, the routines must be developed and tested and the resulting data must be validated by the developer before they are turned over to the ETL architect for migration.

When several routines are given to the developer at once, which is usually the case, an ETL build sequence document is usually prepared by the ETL architect for the developer to use as a guide. Shown in Figure 10.5, the document contains a listing of the expected tables to be loaded, the ordinal position to build the processes, and comments as to what challenges should be expected in the routine. This document is especially important during the first phase of the project or for developers new to your team.

Figure 10.5 ETL build sequence document.

Testing the ETL Processes

Most systems’ lifecycle methodologies include three phases of testing. During your ETL, it is recommended that you follow the three-phase approach when going live with new source systems, subject areas, or any major release. Following are the three types of testing that should be conducted with each phase of your ETL project.

Unit Testing. This testing occurs during and after development before going to QA testing. This testing is performed by the ETL developer and the systems analyst in the development environment.

Quality Assurance Testing (QA). This is the testing that typically occurs by a separate group within your organization in a separate environment mirroring production. The environment is created and controlled by the DBA and QA team members. This environment will be used to ensure all ETL processes are performing as expected, meeting all business rules and timeframe (load window) requirements. Given that it simulates the production environment, the QA group can validate that the ETL processes will work in production.

User Acceptance Testing (UAT). This phase typically occurs by your user group in a separate controlled environment created from the QA environment. This database is controlled by the DBA team members. In smaller organizations, after QA testing is complete, it is acceptable to open the environment to users for user-acceptance testing, reducing the cost of infrastructure maintenance and hardware. UAT is the testing phase that benefits the team by letting users have a hands-on look at the data to ensure processes are running as expected. At the end of UAT, obtain sign-off from your users. Once sign-off is received, you are ready to move to production.

We’ve been on projects where the user-acceptance testing phase is bypassed for small build releases and bug fixes, going directly from quality-assurance testing to production. In these cases, users inevitably detect issues after code has been pushed into production. Excluding the user-acceptance testing phase is a short cut that prevents you from discovering issues that only a user might find before it is too late: in production.

When testing new ETL processes, be sure to have users test for known data issues and source system anomalies. Not only will this validate your efforts; exposure to the clean data will excite your users and make them eager to use the new data warehouse. Clean data tends to have some positive effects. Users will enthusiastically spread the word of the success of the ETL and data warehouse project, causing other subject areas to flock to the data warehouse project manager begging to be next in line for their data to be transformed and loaded into the data warehouse.

Developing Test Cases

While ETL development is taking place, using the business rules and data defects document, the systems analyst and ETL architect are jointly responsible for developing detailed test plans for unit testing, QA testing, and UAT.

Test plans should include cases that test all business-rule scenarios. Validating test results against expected results ensures that the ETL code is correct and the transformations are working as designed. Your test cases should deliberately try to load poor data into the data warehouse. The ETL process should either prevent data from entering or transform data and load it. In either case, an audit report should be generated. Even when poor data is not intentionally loaded, be sure to include queries that test data quality in the data warehouse to ensure that data-cleansing transformations are working as expected.

Most likely, issues will be identified during the validation of the test cases. Some of these issues may be bugs discovered in your code, and some may be fresh ideas triggered by the users’ exposure to their data in a format that is new to them. It’s not uncommon to receive user requests for new requirements during this phase that may need to be added as enhancements. Be careful: Data is not the only thing being tested here. Managing the initial ETL processes is a task in itself; add on bug fixes, additional requests, and ever-changing business rules and the process can become completely unmanageable. In-depth change management techniques are detailed in the “Managing Scope’’ section of this chapter.

A sample test case template is illustrated in Figure 10.6. It is intended to capture the requirements you are testing; the detailed steps to perform the test; the expected results; and the status of the test: pass or fail. Sample test cases are given to display the level of detail you should capture. This template should be used for all three phases of the testing process.

Figure 10.6 Test case template.

ETL Deployment

Next comes the moment you have all been waiting for: ETL deployment. To make the migration to production as seamless as possible, be sure to create production support documents. These documents should include following information:

The final lineage report

Procedures for running (and restarting) the incremental load process

Details about the automated load schedule

It is important to create and deliver documented failure recovery procedures. Should a load process fail, users could have access to bad data or data that is not up to date. A plan must be in place to avoid this before the production environment is unleashed to users. Document and test your failure recovery procedures, so that when failures occur, you can quickly recover data and make it available for your users in a timely manner.

Work with the DBA team to create a stable production environment. Load your historical data and kick off the ETL incremental load processes with your production scheduler. Be sure to run tests on data in production (historical and incremental) to ensure data was successfully loaded.

Maintaining the Data Warehouse (ETL)

Depending on how your organization is structured, the data warehouse project manager and DBA team are typically responsible for the ongoing maintenance of the data warehouse. However, you are the owner of the ETL process, and unless other arrangements have been made, its ongoing maintenance is your responsibility.

After you go live in production, it is important to continuously monitor your data warehouse for known content issues. Part of this maintenance includes the development of audit reports that will capture known issues. These audit reports should stem from the business rules and data defects document. The reports can automatically be sent to the appropriate contact personnel for action via e-mail.

Patches and upgrades are inevitable in any production IT environment. Such patches and upgrades are especially relevant in the data warehouse environment, where so many distinct tool sets are integrated for a single solution. Be diligent in applying patches and upgrades as necessary. It is recommended that you schedule regular system maintenance and perform these upgrades during this time. All patches and upgrades must go through the full development lifecycle, including unit testing in the development environment, QA testing, and user-acceptance testing. Passing the patches and upgrades through testing ensures that maintenance was performed correctly and that all processes are running as expected.

Keep your users abreast of new releases or enhancements as they are being rolled out to production. That communication helps users prepare for changes as they enter the data warehouse. Your users could be waiting for a specific release or enhancement. Giving them a heads up on the time frame of scheduled releases will boost their experience with the data warehouse.

Managing Scope

It won’t be far into the project when you realize why defining scope and obtaining sign-off is so important. It’s easy to lose control when you are trying to tackle the overwhelming bombardment of change requests.

Unmanaged ad-hoc changes to the ETL specifications can be detrimental to the success of the project. It is common to receive additional requirements during the development and testing phases. Issues will certainly be found and new ideas will most likely surface, all of which need to be implemented immediately. In our experience, when the data warehouse is unveiled, new wish lists and requirements excitedly begin to trickle in, picking up momentum exponentially as more subject areas are deployed. Before you know it, you will be bombarded with more work than you and your team can handle. Did someone say scope-creep? Creating a mechanism for tracking and managing these changes is crucial to your success. The next section provides the documents you need to track changes and recommends procedures that help you execute them.

Change Tracking

Implementing a process to track enhancement requests, bug fixes, or cha-nges to the initially agreed scope is essential to your success as the ETL manager. Following is a list of elements that have proven to be significant while capturing and tracking change requests. You will want the ability to track and manage the following information even if it means creating a simple spreadsheet to do it. Capturing the following elements aids in the management of changes and helps minimize scope-creep.

A system could easily be built in Microsoft Access or any small personal database application for this purpose. For larger groups, you can implement a small Visual Basic application or can leverage packaged systems that your organization has already invested in. And, of course, a good ETL tool may provide this capability.

Subject Area. This is the name of the data mart (portion of the data warehouse) the request is being submitted for.

Request Date. The date the request originates

Change Description. This should capture a high-level description of the request.

Priority. High, Medium, or Low. This is a negotiated rating of the importance of the request.

Change Type. Indicates whether the request is for a new requirement or a change to an existing process

Status. Status values can include anything that identifies the state of the request. Values we’ve used include New request, Developer investigating, Developer developing, More information needed, Cancelled, Passed unit testing, Passed QA, Passed UAT, Ready for production, and so on. The values in this field change throughout the life of the request.

Submitter. The name of the person submitting the change request

Owner. Indicates the person responsible for the request at a specific time. It usually begins with the data warehouse or ETL manager and then gets assigned to the appropriate developer, tester, or so on throughout the life of the request.

Version Found in. This is the active version number at the time the bug is detected or the request is submitted.

Version Fixed in. This is the number of the version that the request is packaged with when released to production.

State. Open or Closed. Closed should be selected only when the Status is set to Released to production or Cancelled.

Date Closed. This field should be populated at the time the state field is set to Closed.

Functional Description. The information provided here should describe the user’s experience prompting the request.

Technical Description. The information provided here is usually filled in by power users or the ETL architect. It is used by the developer for coding the change or new requirement.

Having the ability to generate reports using the elements from this list is advantageous. If you have the resources to develop this as an IT system, consult with your team to get their input on the process, making sure the process meets the needs of everyone on your team.

However, minimizing changes to the production data warehouse environment is a good practice, if you can achieve it. Keep in mind, the more changes made, the greater the risk of affecting other processes. We recommend holding regularly scheduled meetings with appropriate team members to discuss the priority of each request. It is important that you make your users realize how critical it is to minimize changes to production. Make sure they understand the cost and effort it takes to fulfill each request. Have them ask themselves the following questions: What is their return on investment? Are the benefits of the changes worth making? Can they justify the change requests?

Once it is agreed that a change should be made, you must discuss the impact of the change. If the change affects another ETL process or another area, a detailed impact analysis must occur. Proposed changes can result in multiple new changes to existing ETL processes. Be sure to add these changes to your new tracking system.

A sample change/enhancement requisition form is shown in Figure 10.7. This form includes all of the necessary information you need to enter a new request and perform development to complete the request. This form, in conjunction with your change-request tracking system, supports effective management of the change-request process.

Figure 10.7 Change/enhancement requisition form.

Scheduling Version Releases

Typically, a number of changes, enhancement requests, patches, and upgrades are bundled together as a single build or release. Each release must go through the full development lifecycle. Before going to production, be sure to unit, QA, and UAT test your changes. After the changes have passed the testing cycles, either the ETL architect migrates the routines or the DBA team pushes the code to production.

Tracking versions of your data warehouse is beneficial for troubleshooting problems discovered in production. Use the tracking mechanisms outlined earlier in this chapter to maintain control over your version releases. Normally, following standard-versioning techniques works well in the data warehouse/ETL environment. It is especially important for the ETL manager to adhere to this standard because much of the data warehouse code releases to production are created and deployed by the ETL team.

The version number consists of a series of three decimal delimited numbers (##.##.##). The first set of numbers signifies major releases; the second, minor releases; and the third, patches. For example, Version 1.2.1 means the data warehouse is in its first version and there have been two minor releases and one patch applied to it.

In the data warehouse environment, a major version release typically constitutes a new subject area or data mart that includes new facts, dimensions, and ETL processes. A minor release is defined as primarily ETL modifications, possibly including some minor structural database changes. Patches are usually a result of a hot fix, where a mission-critical error has been detected in the production environment and needs to be corrected immediately. If patches are bundled with minor changes or minor changes with a major, only the leftmost number in the series should be incremented and the right-hand numbers are reset. For example, if version 1.2.1 is in production and you have two patches, a minor change, and a major release scheduled for migration, bundling these changes would be considered a single major release. In this case, you would now be at release 2.0.0.

It is good practice to bundle and schedule major releases with enough time between to address hot fixes. With scheduled major releases, perhaps monthly, it is easier to bundle minor fixes into the controlled release environment to minimize code migrations.

Our recommended data warehouse versioning strategy is especially powerful when your project is using the data warehouse bus architecture. In such a case, each data mart in the bus matrix will be a major version release as it enters the physical data warehouse. If your data warehouse is at version 1.0.210, you are most likely not using this matrix and probably not sleeping at night, either.

Summary

In this chapter, we have finally stepped back a little from the myriad tasks of the ETL team to try to paint a picture of who the players are and what are they supposed to think about. We must keep in mind that this chapter and really the whole book are deliberately limited to the back-room concerns of the enterprise data warehouse.

We began by describing the planning and leadership challenges faced by the ETL team; then we descended into the specific tasks that these people face. In many cases, much more detail is provided in the main text of the book.

If you find an error or have any questions, please email us at admin@erenow.org. Thank you!
